1. Preparation

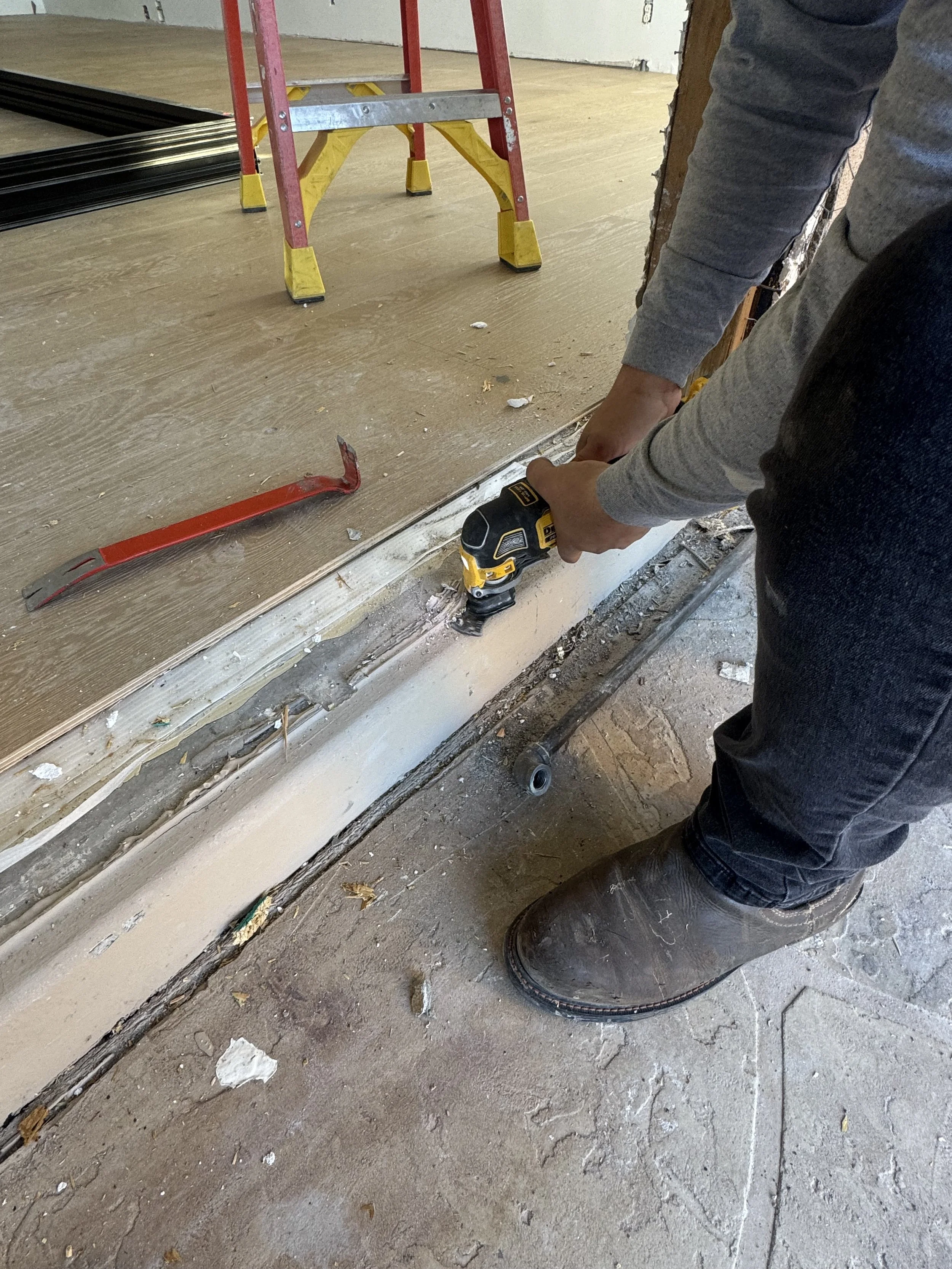

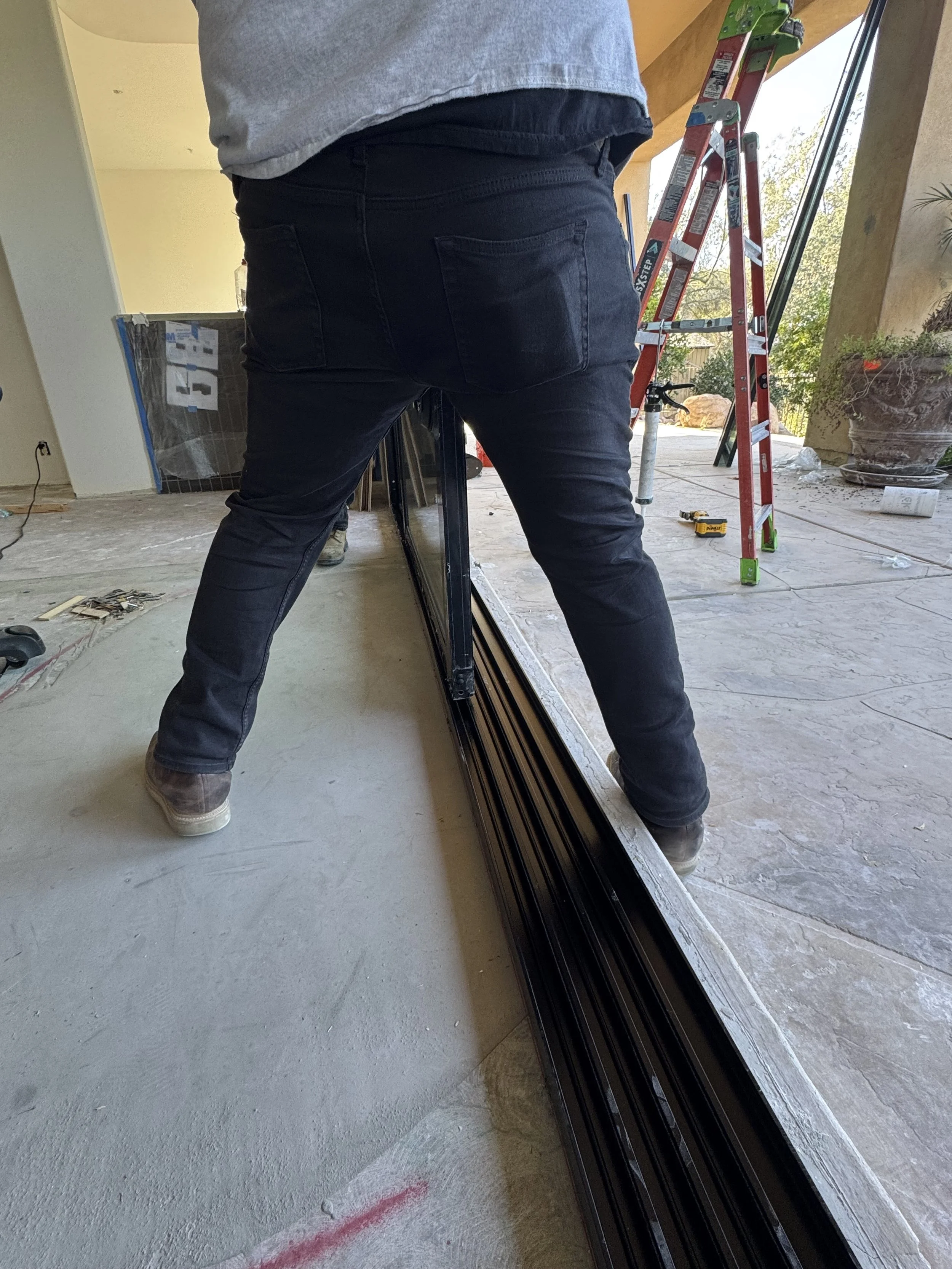

  • Remove old door (if applicable) using all tools necessary.

  • Clean the rough opening of debris and old sealant.

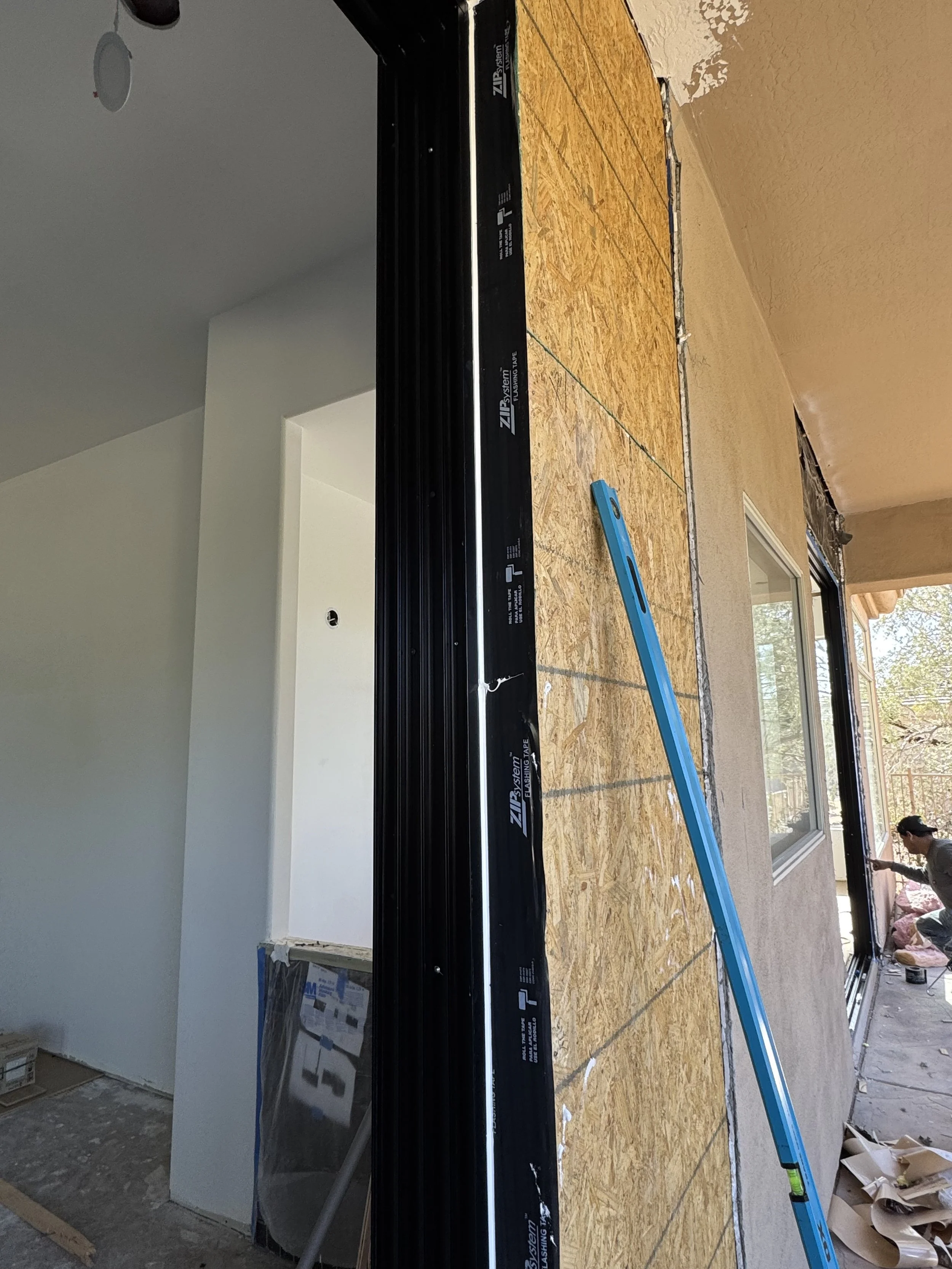

  • Apply the WRB (Water Resisting Barrier) papering or flashing.

A person is using a cordless power drill to remove or install a baseboard or trim along the bottom of a wall in a room under renovation. The person is wearing dark pants and boots, and the floor is scattered with debris.

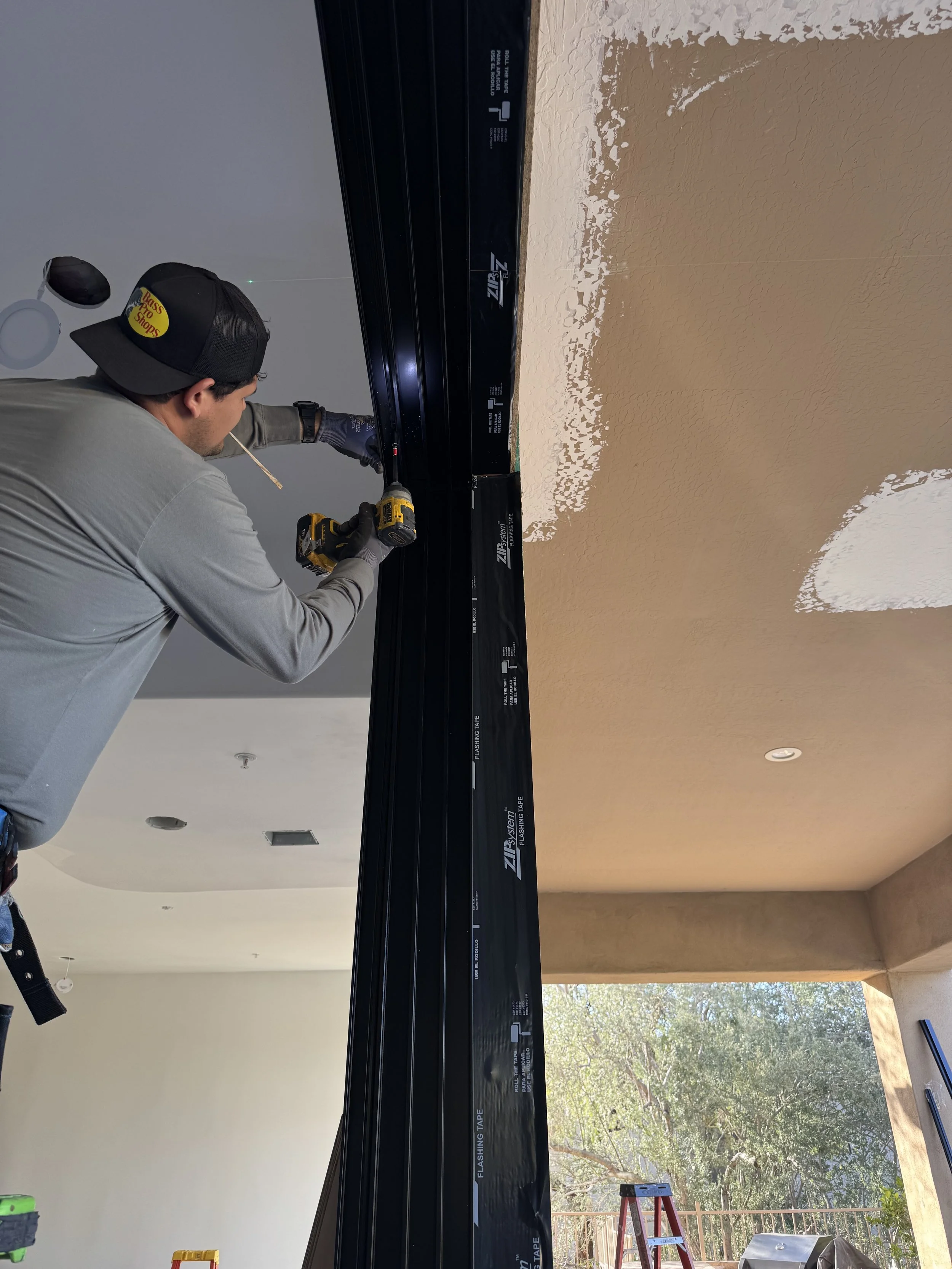

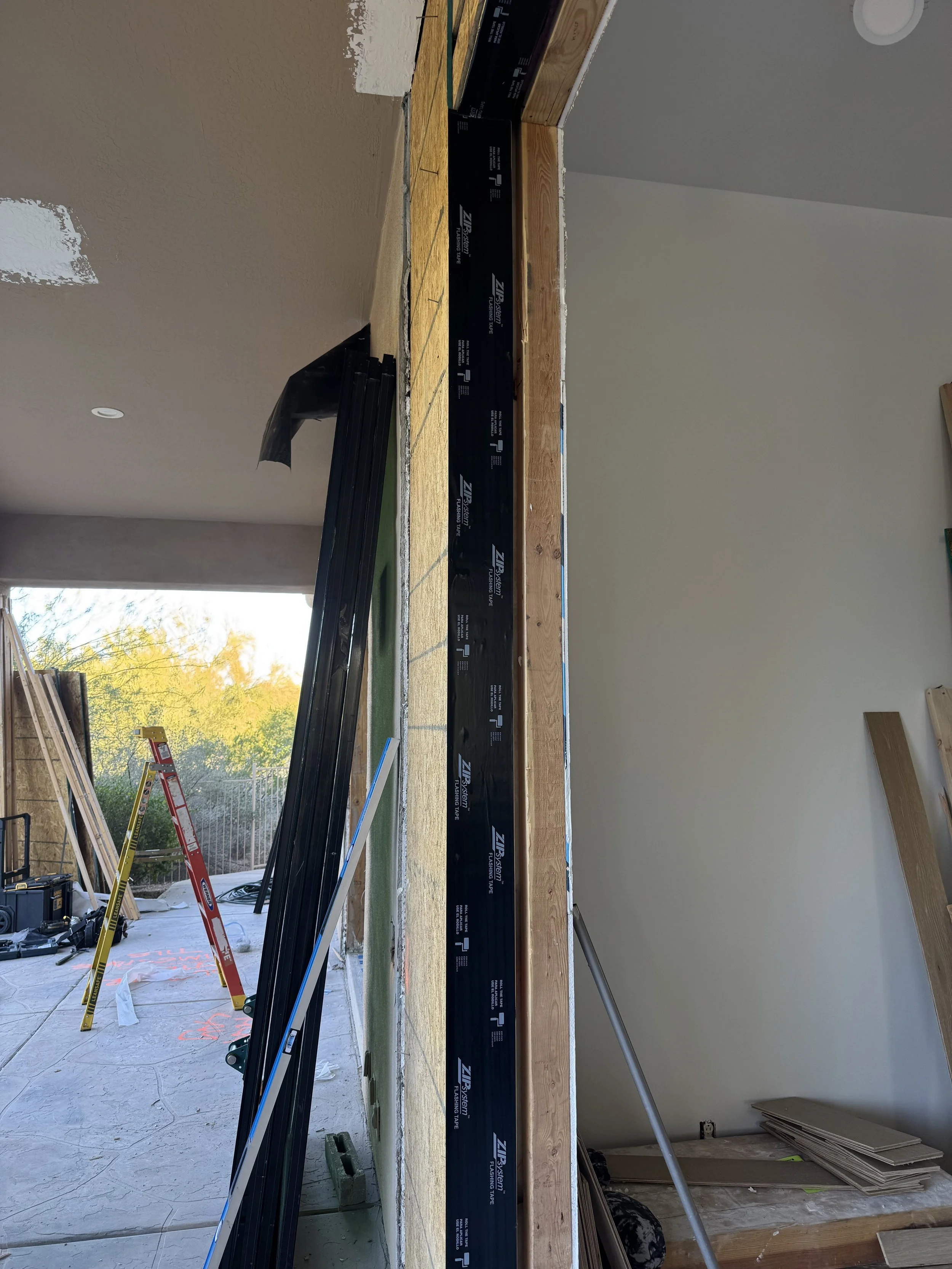

Interior of a house under construction with drywall, a black Zipsystem flashing tape on a wooden beam, ladders, tools, and construction materials.

2. Check Rough Opening Dimensions

Verify that the rough opening is approximately 1/2" to 3/4" wider and taller than the door frame to allow for proper shimming and insulation. Additionally, confirm the following:

  • The subfloor is level across the entire width of the opening, with a maximum allowable deviation of 1/4".

  • The side jambs are plumb (vertically straight).

  • The header is level, and the opening is square (diagonals should measure equally).

Accurate framing ensures smooth door operation, effective weather sealing, and long-term performance.

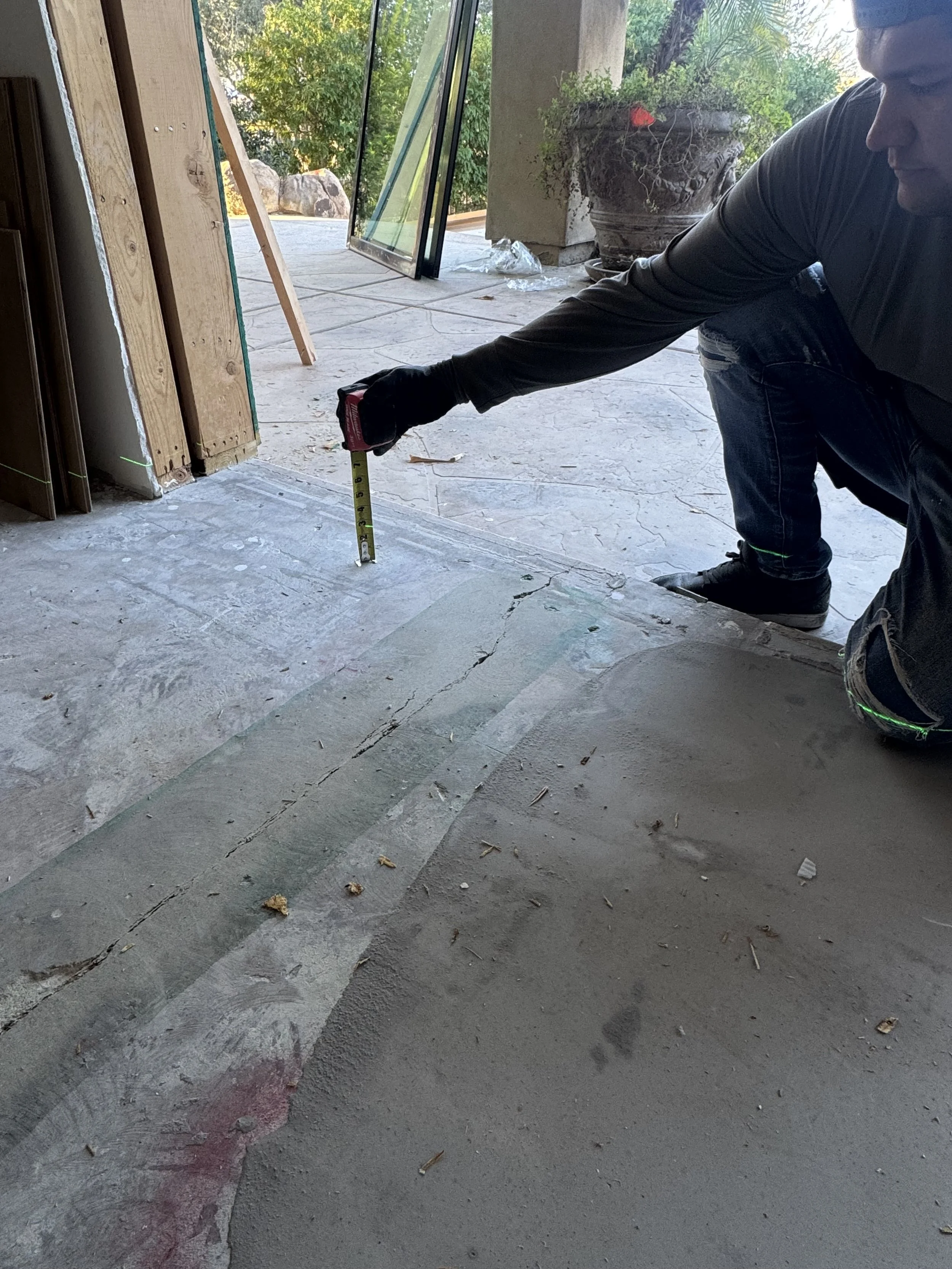

A man in work clothes is kneeling on a concrete porch and measuring the height of a newly poured concrete step with a tape measure.

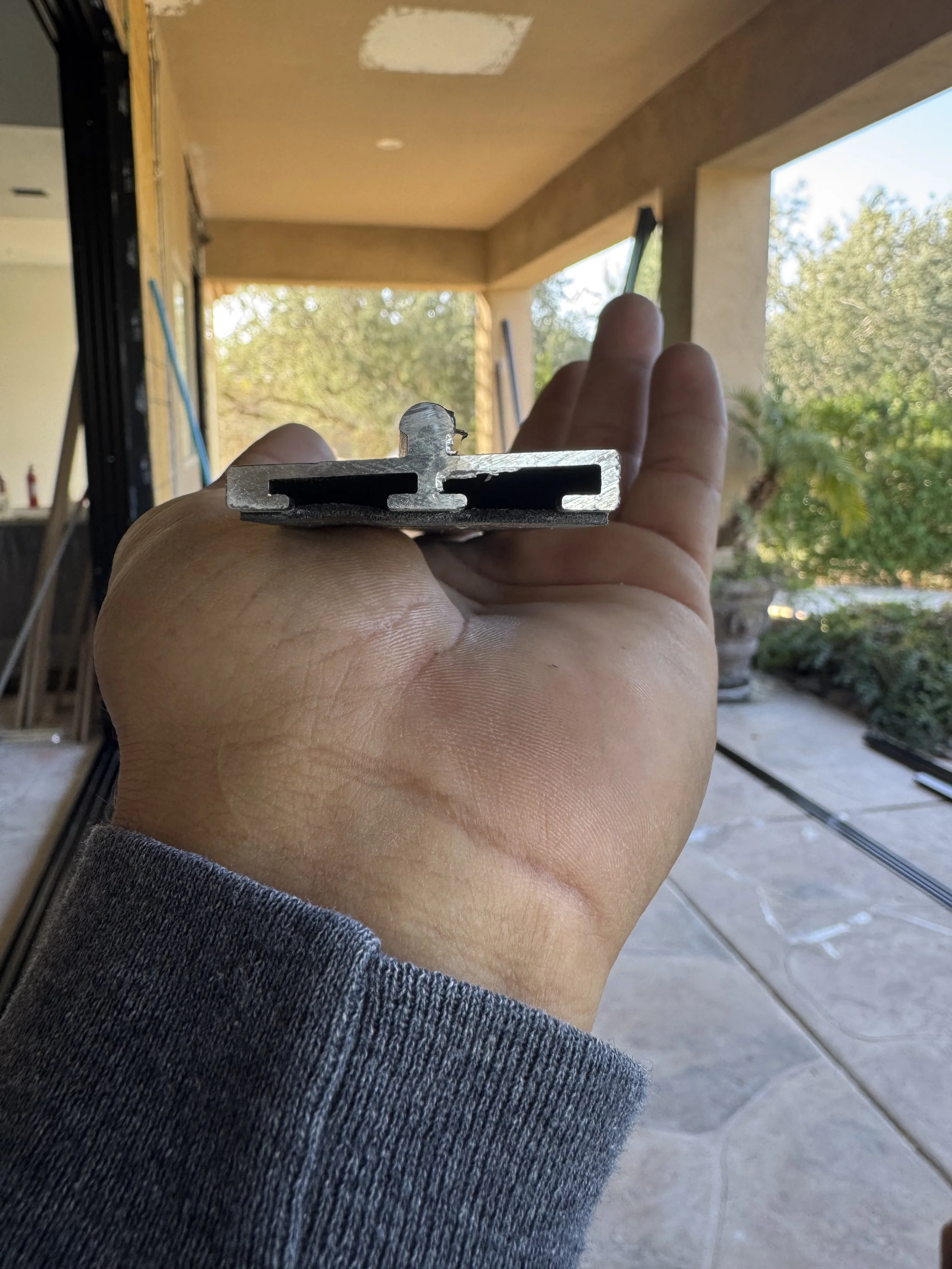

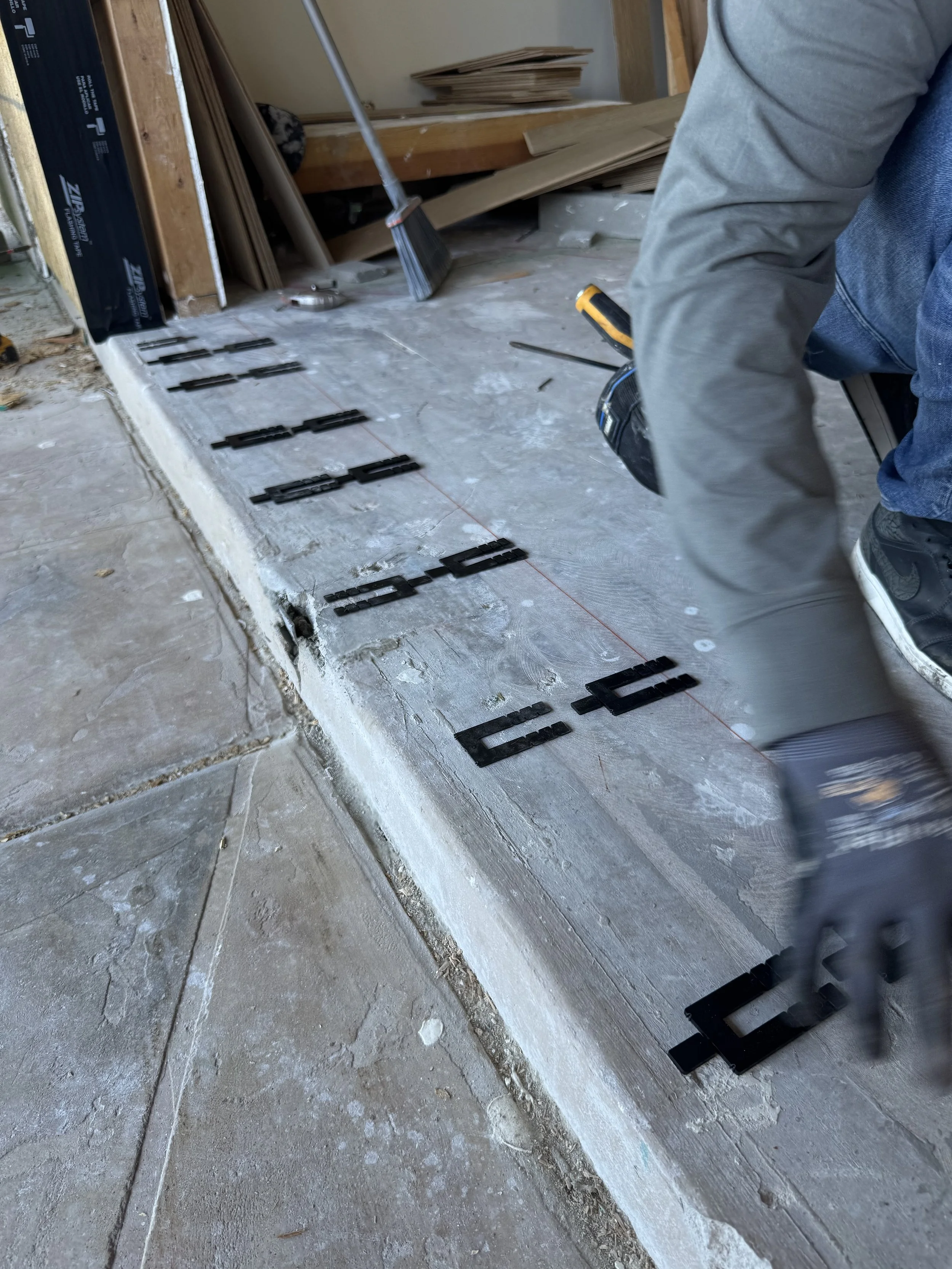

A person working on a construction or renovation project, installing black metal clips or supports on a concrete surface, with tools and materials around.

3. Assemble the Frame

  • If the door is shipped knocked-down (KD), assemble the frame by matching each corner to its corresponding corner marked with the same identification letter

    • Connect header, jambs, and sill with provided screws.

    • Ensure corners are square.

    • Use sealant between the jambs and sill connections for a watertight bond.

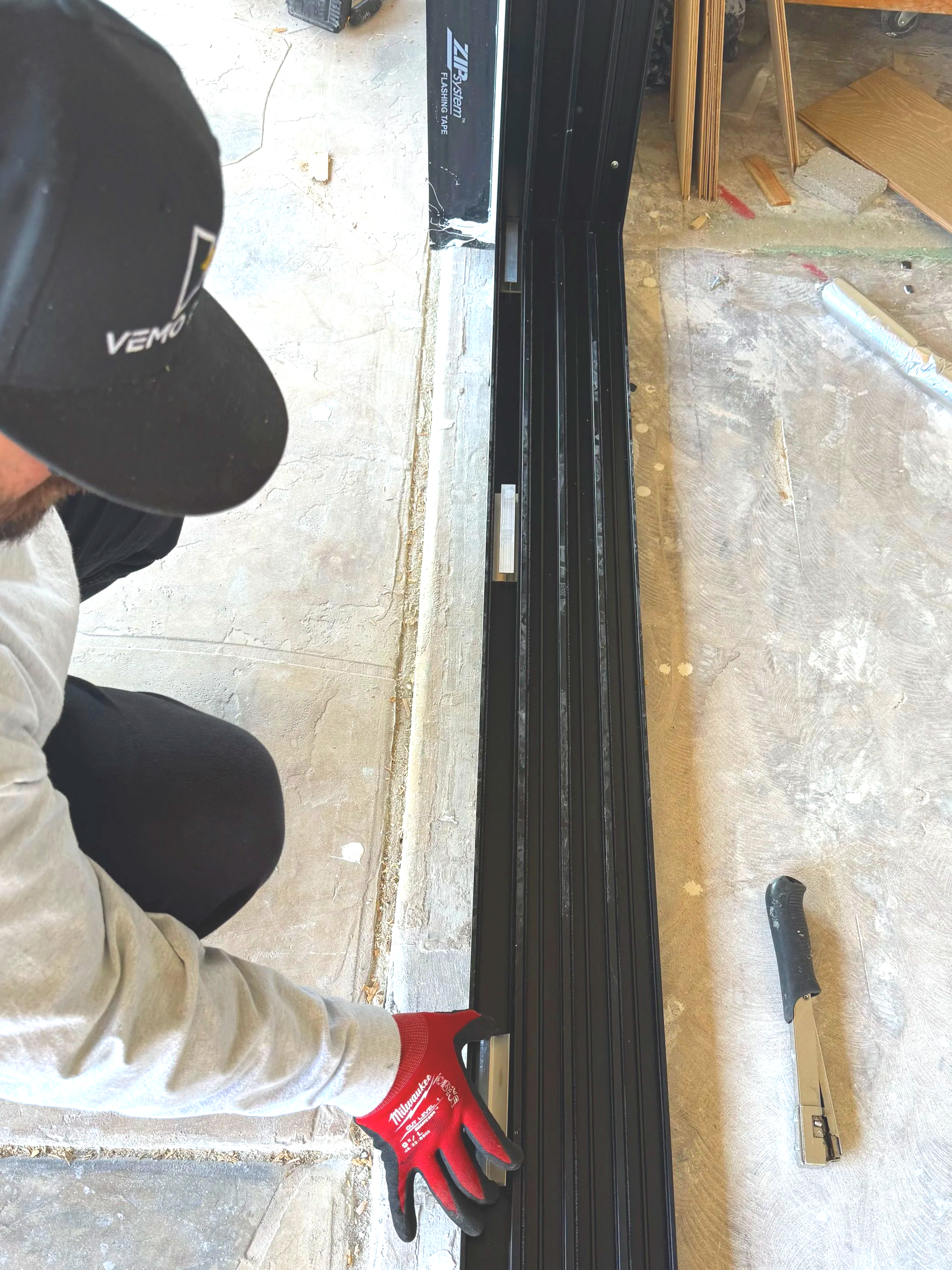

  • Add nailing flange if required:

    • Slide into the frame perimeter before assembling the frame.

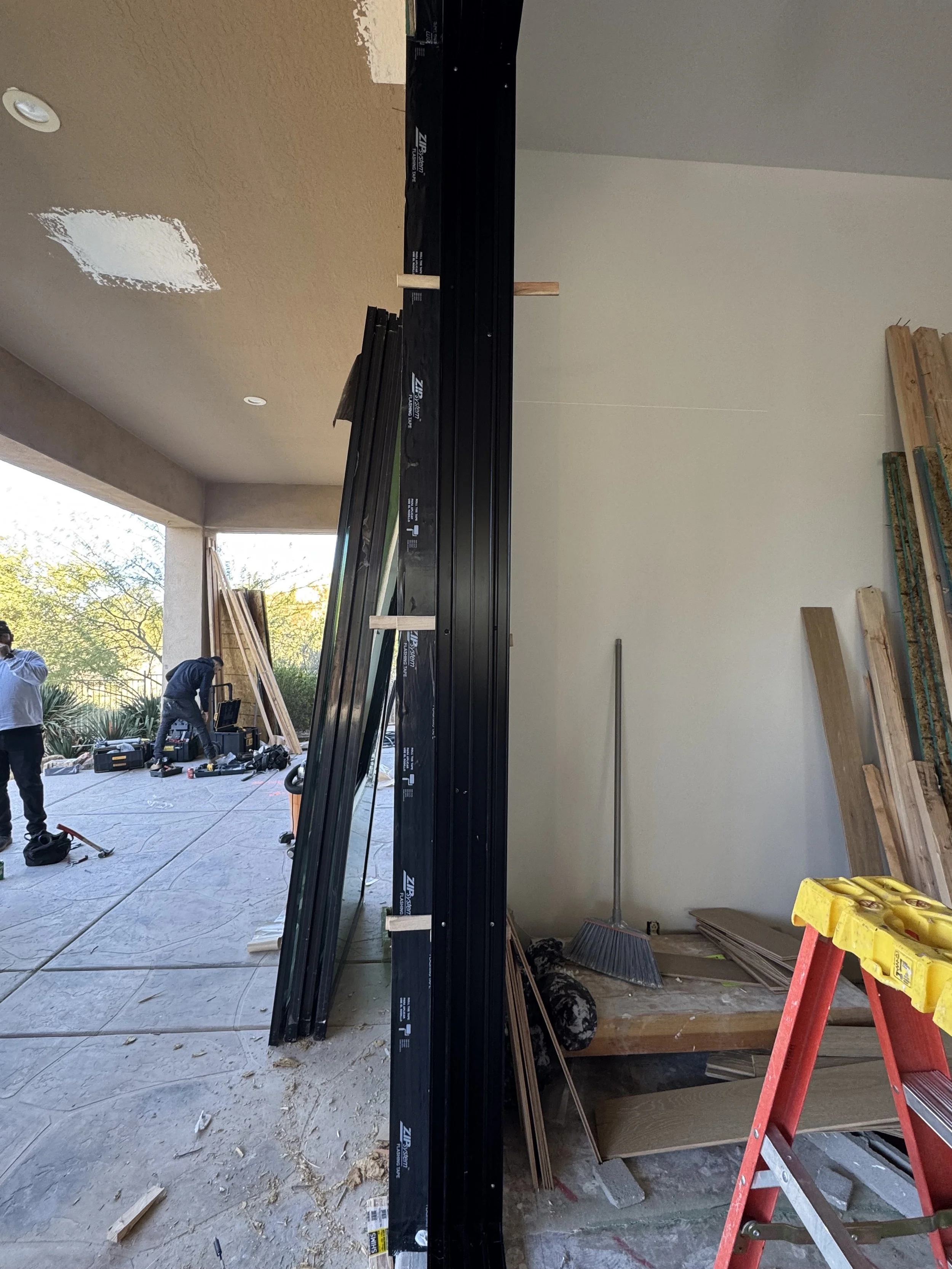

Interior of a building under construction with tools, black metal frame, wires, and unfinished walls.
A concrete floor with scattered paint splatters and chips. Part of a wooden piece and black metal framing are visible at the bottom right.

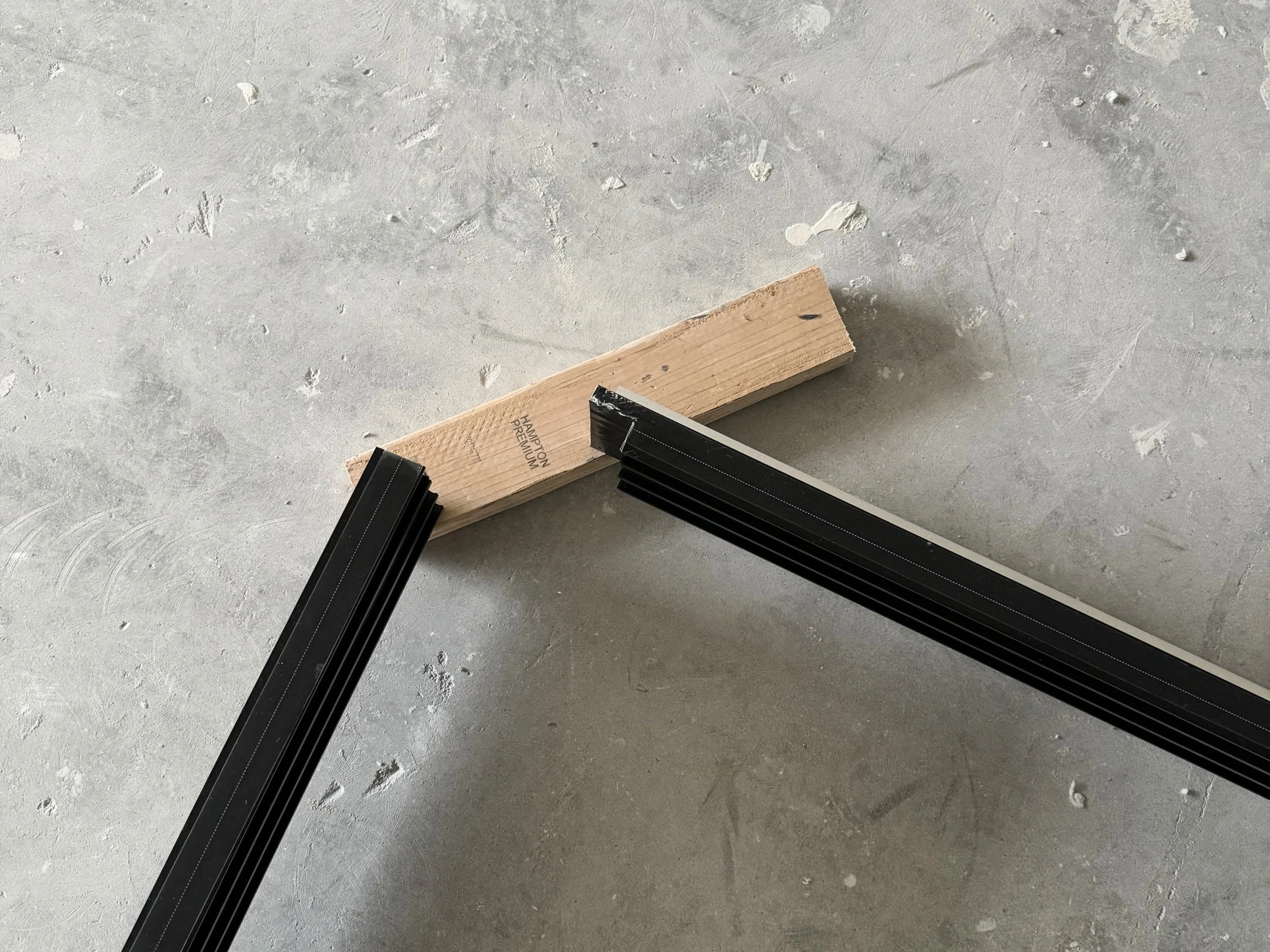

Close-up of a partially assembled picture frame with two red stickers labeled 'A' and 'A' on the black metal border, resting on a concrete floor. Shoes are visible at the bottom of the image.

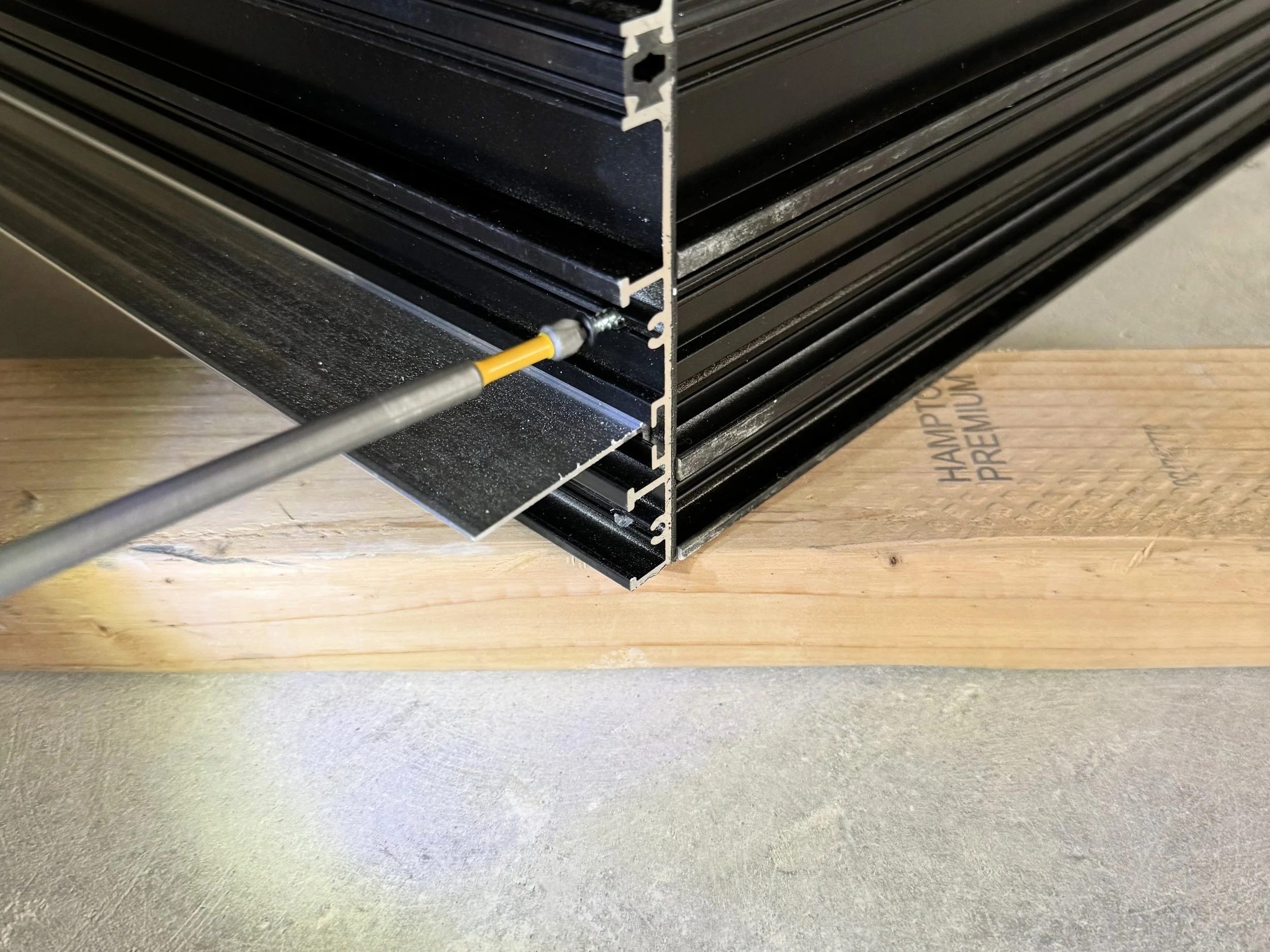

Close-up of a black metal framing with a screwdriver at the corner, resting on a piece of wood labeled 'HAMPTON PREMIUM'.

4. Apply Waterproofing Caulking Beat

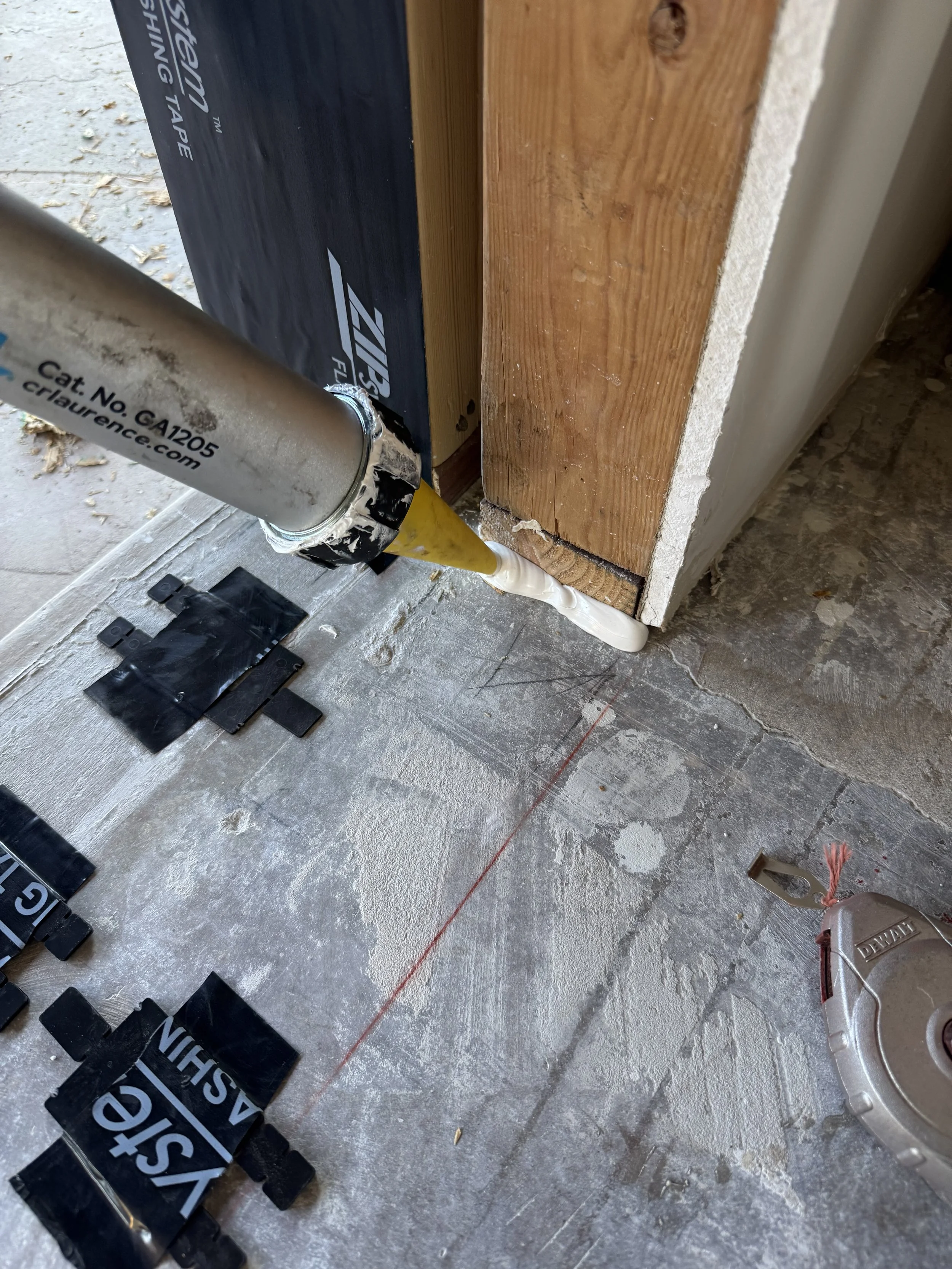

  • Apply a continuous bead of exterior-grade caulking along the floor line beneath the door and extend it at least 4 inches vertically up both jambs. This creates a watertight seal to help prevent moisture intrusion at the base of the opening.

  • If the door includes a nailfin flange, apply an additional bead of caulking behind the nail fin before setting the frame, ensuring a complete perimeter seal against water and air infiltration.

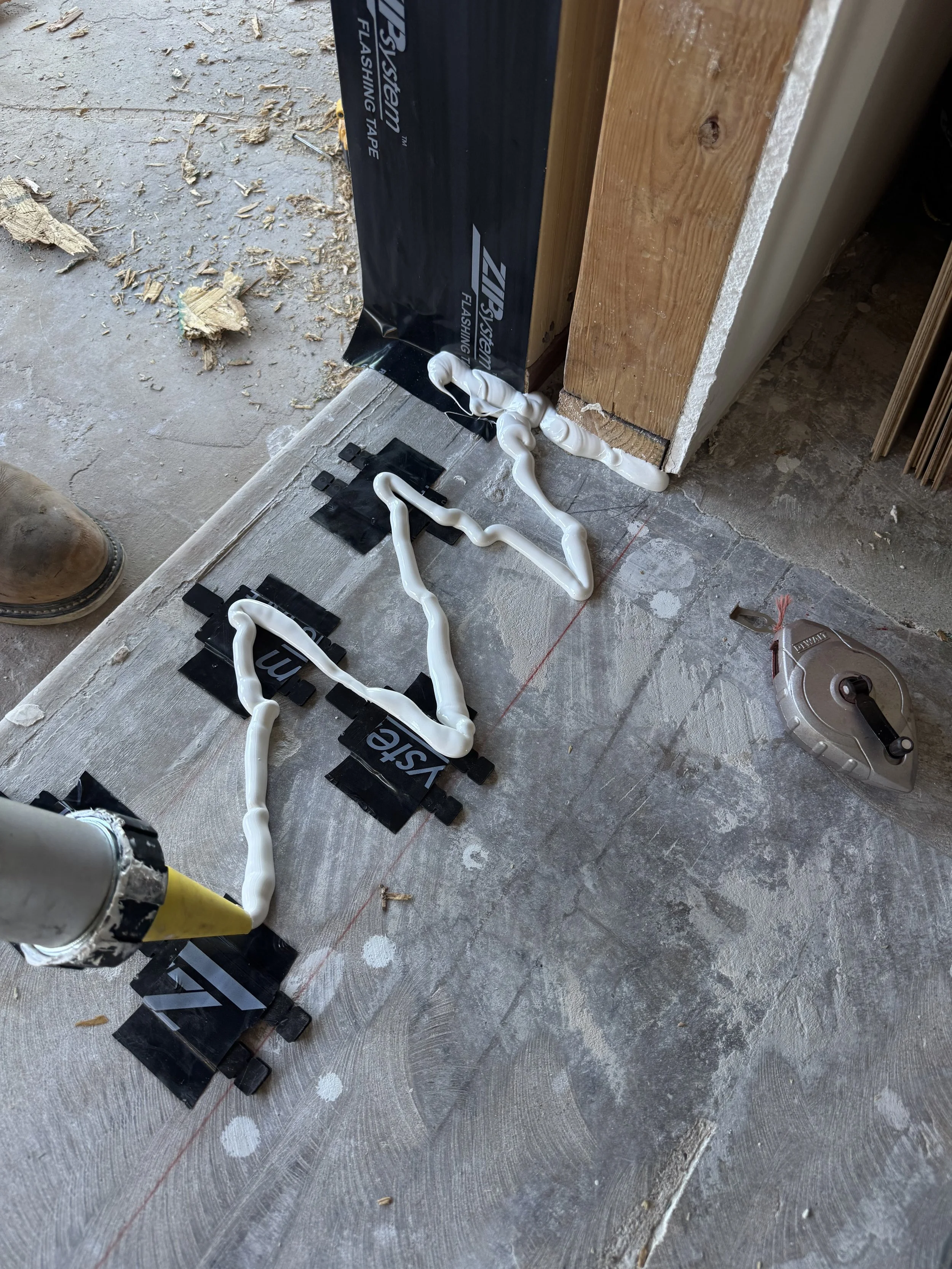

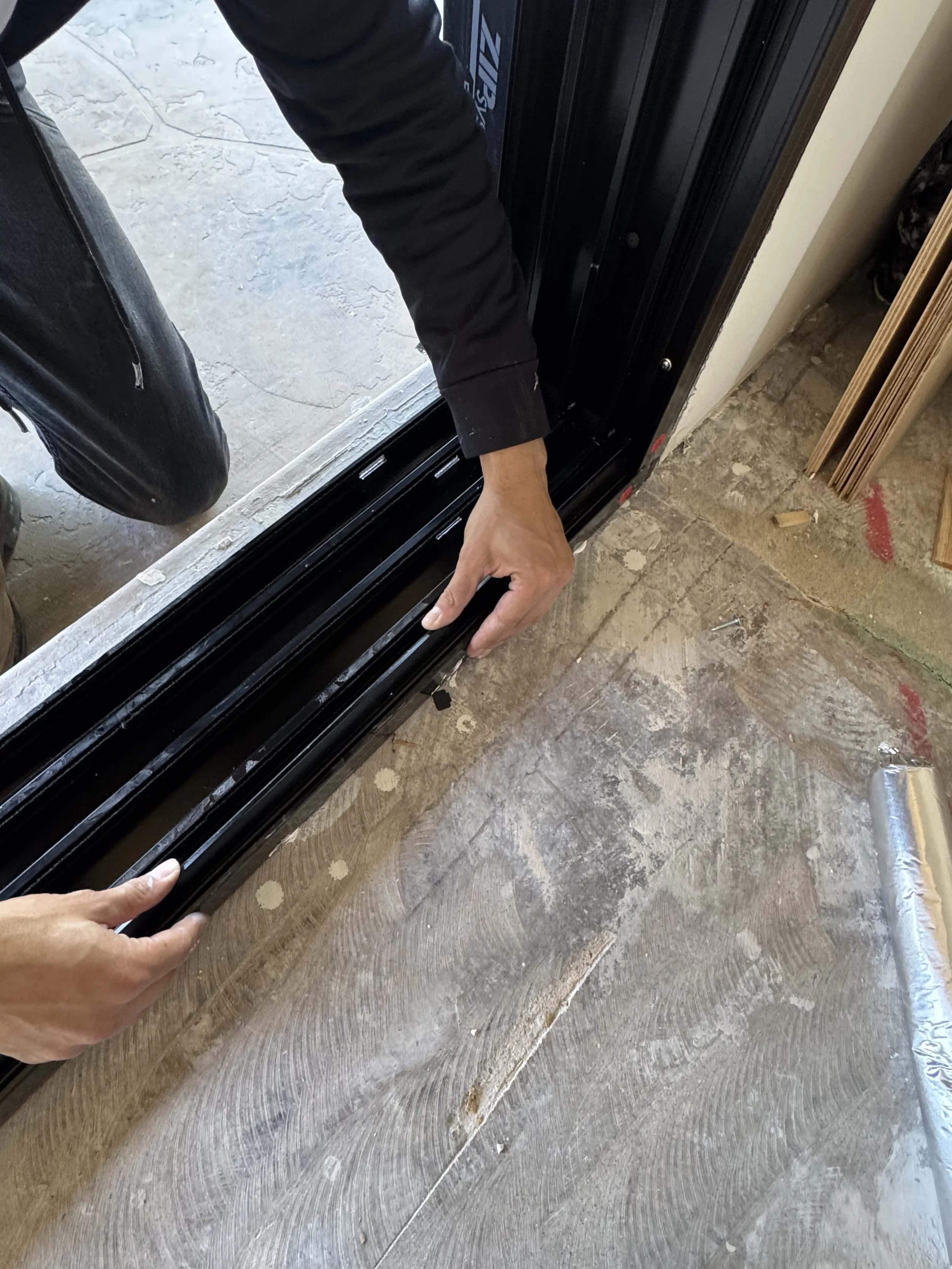

Close-up of a construction or plumbing scene showing a tube of sealant or adhesive at the base of a wooden door frame, with black debris or insulation pieces on the concrete floor, and a red string or wire stretched across the floor.
Construction site with drywall, saw, and foam pipe insulation.

5. Set & Secure the Frame

  • Insert the frame into the prepared opening and press it firmly into place, verifying that it is square, level, and plumb. Use shims as needed to adjust and maintain proper alignment before fastening.

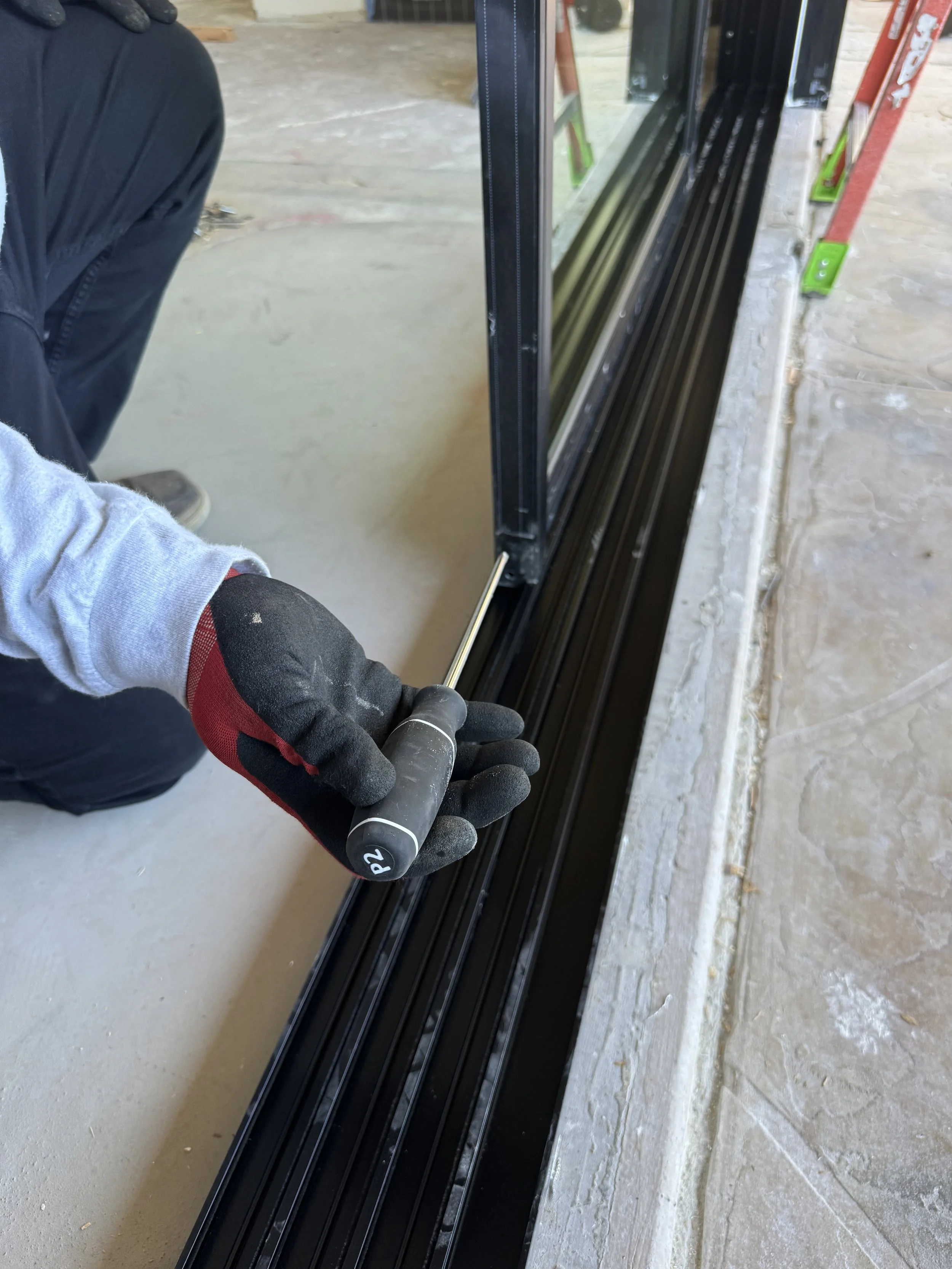

  • Fasten the frame through the nail flanges, typically every 16", using appropriate exterior-rated screws.

  • Additionally, install screws through the interior channels of the frame at the head and jambs to provide added structural support and prevent frame flexing or movement over time. (Add shims behind each screw on jambs)

  • Confirm the frame remains square during fastening to ensure proper panel operation.

A man installing black window trim in a room with white walls and a large window showing trees outside, using a cordless drill.
Construction site showing black metal beams, wooden planks, a red step ladder, a yellow workbench, and workers installing or working on the framework under a covered patio area.

6. Install Track System

  • Install the track system into the frame channels prior to panel installation. Verify the track is sloped to the exterior for drainage. Tracks are required only for roller-operated (movable) panels.

  • For fixed panels, install the proper two-piece blocking system into the exterior-most frame channel to secure the panel in place.

A person holding a metal object in their hand, with an outdoor background showing trees and a building under construction.
Worker installing a black metal window frame, wearing red Milwaukee gloves and a beige work shirt, in a construction site with unfinished flooring and scattered materials.
Person installing or inspecting a black window or door frame in a construction or renovation site with wooden flooring and unfinished surroundings.

7. Install Panels

  • Install the sliding panels into the track system by lifting each panel fully into the upper channel, then carefully lowering the bottom onto the track.

  • Once in place, adjust the rollers as needed to ensure smooth operation and achieve consistent reveals along the head, jambs, and interlocks.

Workers installing a large black door frame in a room with unfinished walls and ceiling, tools and equipment scattered around, ladder and construction supplies visible.
Construction worker installing a large black window or door frame in a room with unfinished concrete floors, a ladder, and construction tools visible around.
Person installing black sliding door or window frame with tools in a construction site.

8. Seal, Flash and Insulate

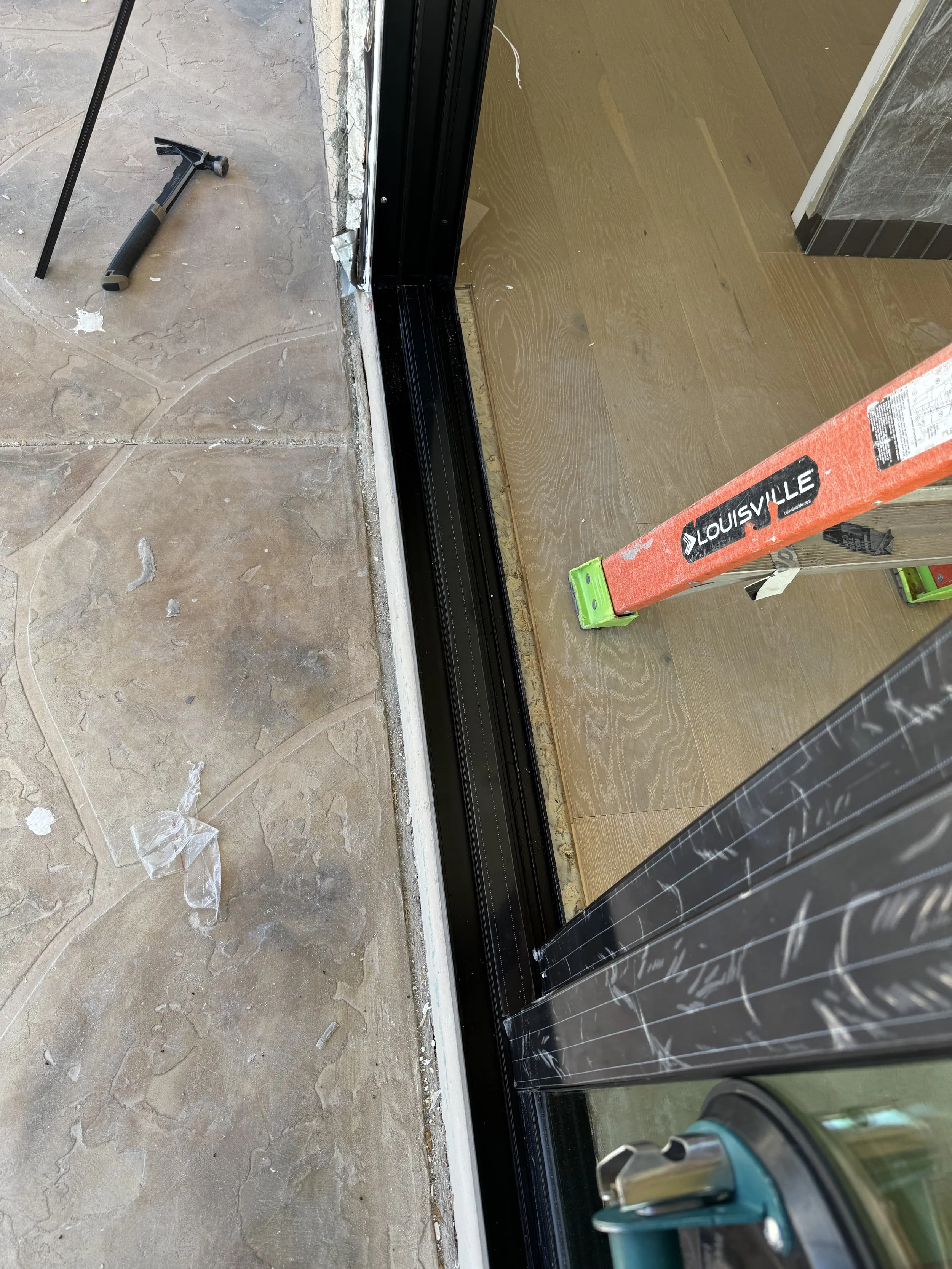

  • Use exterior flashing tape around the top and sides of the frame.

  • Apply a continuous bead of exterior-grade sealant along the interior and exterior edges at the bottom of the frame (When possible). This enhances moisture resistance and ensures a more effective seal between the frame and the subfloor.

  • From the interior, apply low-expansion foam between frame and framing cavity.

  • Avoid overfilling to prevent frame distortion.

Construction room with a partially installed window, a level tool on the floor, and building materials. The walls are unfinished, and there is a person working outside visible through the window.
View of a storefront with a large glass window and adjacent plywood wall, reflecting trees and a person inside the store. Two signs on the window say 'Vemo Doors'.

9. Handle Installation

  • Insert the exterior handle into the pre-drilled holes in the panel.

  • From the interior side, align the interior handle with the exterior handle.

  • Install the provided through-bolts or screws, tightening evenly to avoid misalignment.

  • Do not overtighten, as this may damage the panel or hardware.

  • Position the strike (striker) on the frame at the correct height so it aligns with the handle/lock mechanism.

  • Secure the strike to the frame using the provided fasteners.

  • Test handle and lock operation to ensure smooth engagement and proper alignment.

Note: Handle and strike installation applies only to operable (sliding) panels.

A person opening a glass door with a black handle.

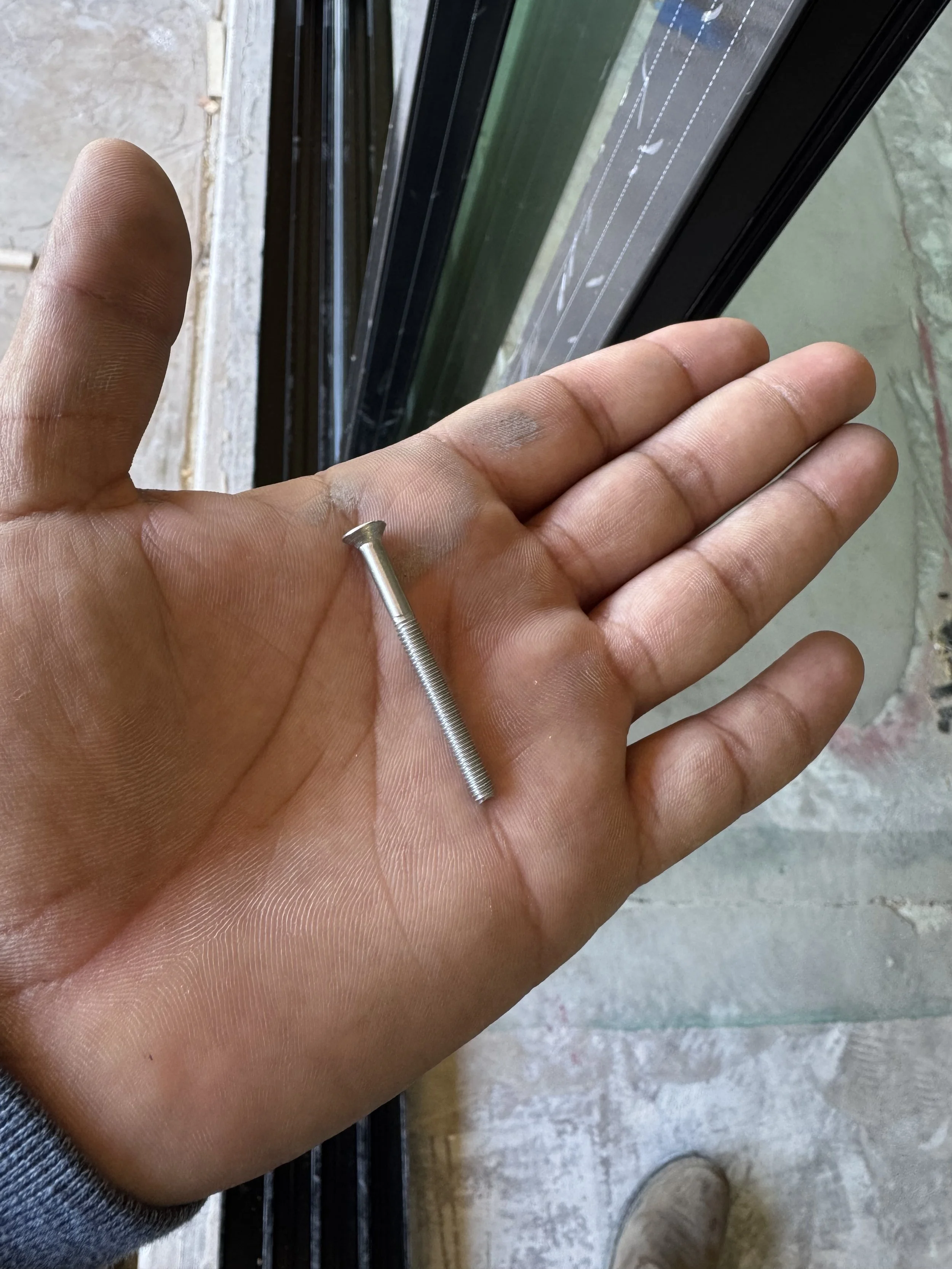

Close-up of a person's hand holding a small metal screw near a window frame.

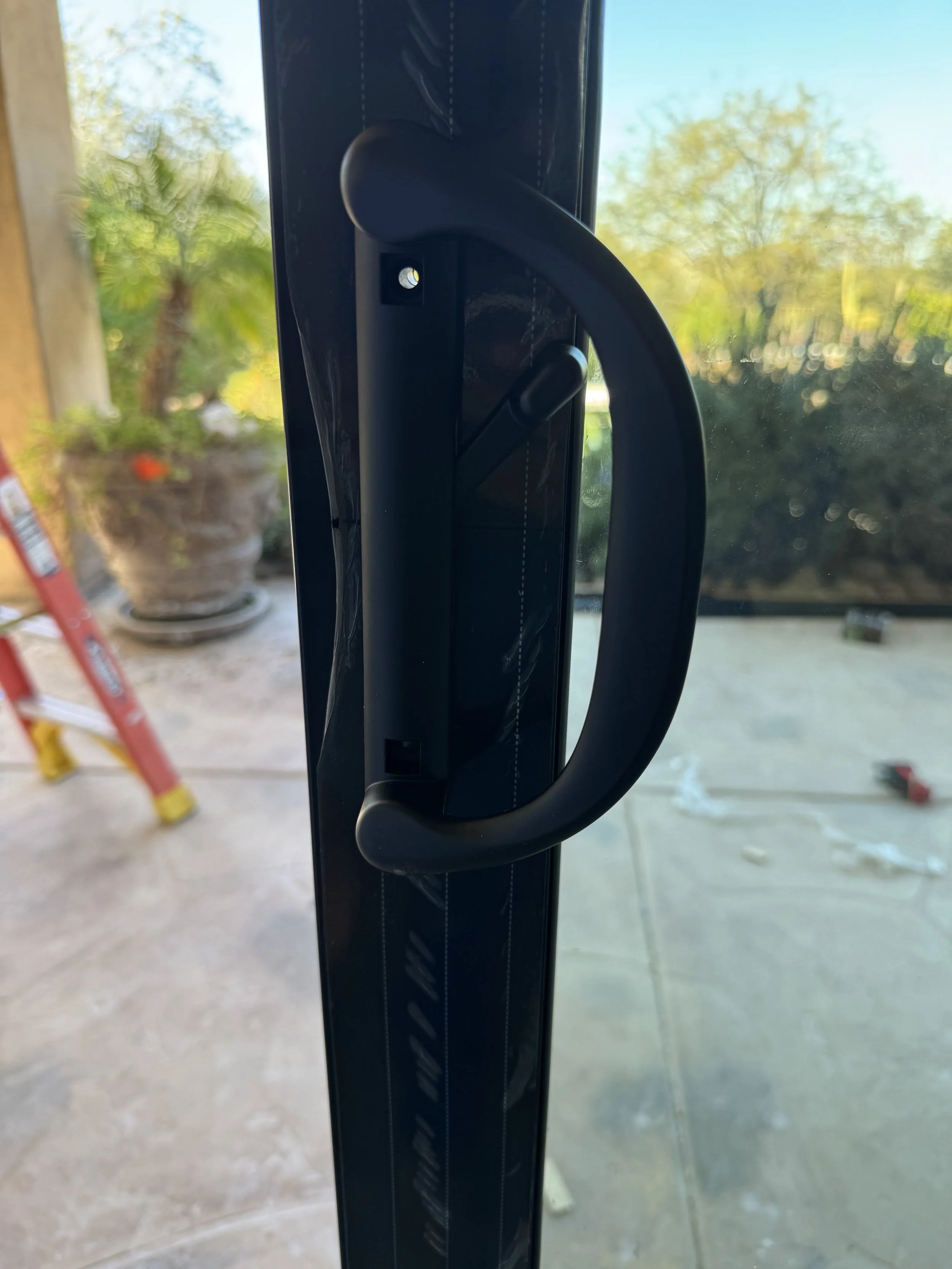

Close-up of a black door handle on a glass door with a cityscape and trees in the background.
Close-up of a black metal door latch or lock mechanism with screws, partially installed, with a wooden board leaning beside it. Blurred background showing a bottle and some furniture.

10. Cover Installation

  • Push the fixed panel fully into the exterior position (all the way to the back of the frame).

  • From the interior, lock the operable panel.

  • Verify the door locks smoothly and correctly.

    • If the door does not lock properly, adjust panel alignment before proceeding.

  • Leave the door locked to hold the fixed panel in its final position.

  • Go to the exterior side to begin installing the covers.

  • Measure, cut, and install the bottom and top covers to the exact length needed in the field.

    • Bottom and top covers are supplied longer than needed to allow field trimming.

  • Install the side covers (no cutting required, they are pre-sized).

  • Confirm all covers are securely installed and sit flush with the frame.

Tip: Always trim and install the bottom and top covers first, then install the sides for proper alignment and a clean finish.

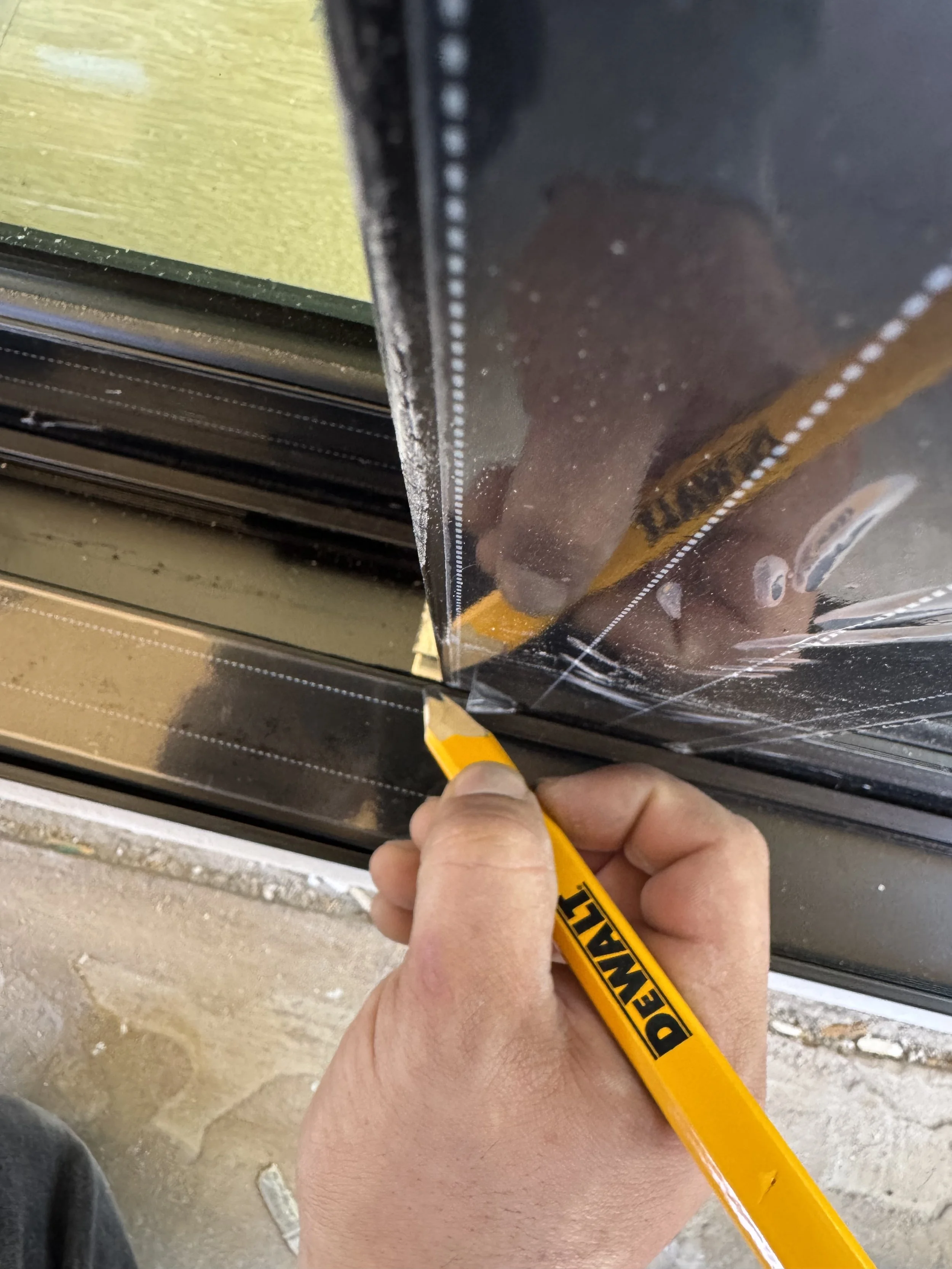

A person using a yellow utility knife to cut plastic or film along a glass door or window frame.
Interior of a building under construction with a black window or door frame, a ladder labeled 'Louisville,' a cordless drill, a window rail, and scattered debris on the floor.

11. Final Checks

  • Verify all panels are properly aligned and operating smoothly.

  • Confirm the track system, handles, and strikes are correctly installed and functioning.

  • Secure the fixed panel by installing screws through the main frame and into the fixed panel frame, per manufacturer specifications.

  • Ensure fasteners are properly set and do not interfere with panel operation.

  • Install the roller adjustment hole covers after final panel height and alignment have been set.

  • Clean the frame and glass, and remove any installation debris.

Interior view of a black oven with metallic heating elements and a glass door. Green plants are visible outside through the oven's glass door.
Front view of a building with large glass sliding doors, two wall-mounted lantern-style lights, and string lights overhead. Inside, a porch swing and seating area are visible through the glass, with signage for 'Vemo Doors' on the windows.
